Operational case study

CrystalClearWater
Environmental.

CrystalClearWater Environmental. What is complete, what is observed, what remains projected, and which decisions are still open.

27.6Hours recovered per weekRecorded at the dashboard status point shown; 37% of the 74.3-hour model.
4 of 6Delivery stages completeThe agents stage is in progress; automation remains ahead.
$1,260Monthly software removedEleven subscriptions shown as cancelled or reduced.
2Open client decisionsOne is shown as overdue in the delivery record.

Progress, value, and the decisions still ahead.

The dashboard combines delivery gates with operating measures, making incomplete work and client dependencies visible.

CrystalClearWater delivery dashboard showing current phase, recorded hours recovered, steps complete, client decisions, software removed, and six delivery stages.
Figure 01 · Four of six delivery steps are complete, 27.6 hours per week are recorded, and the agents stage is in progress. On smaller screens, scroll the image horizontally to inspect it.

“Build and migrate” was specific to this engagement after the audit identified a required data move. Migration is not assumed for every Ergofect pilot.

A forecast stays a forecast.

At the status point shown, the record contains 18.4 hours from consolidation and 9.2 from agents. Automation is still zero. Later bars remain visibly projected.

Stacked bar chart and evidence table separating recorded hours recovered from projected consolidation, agent, and automation capacity.
Figure 02 · The dotted 74.3-hour line is the modelled opportunity. Future months and automation contributions are projections, not published production outcomes.

Decisions and risks stay in the record.

See where client input is blocking scope, where measurement is incomplete, and which imperfect records were accepted with a named decision.

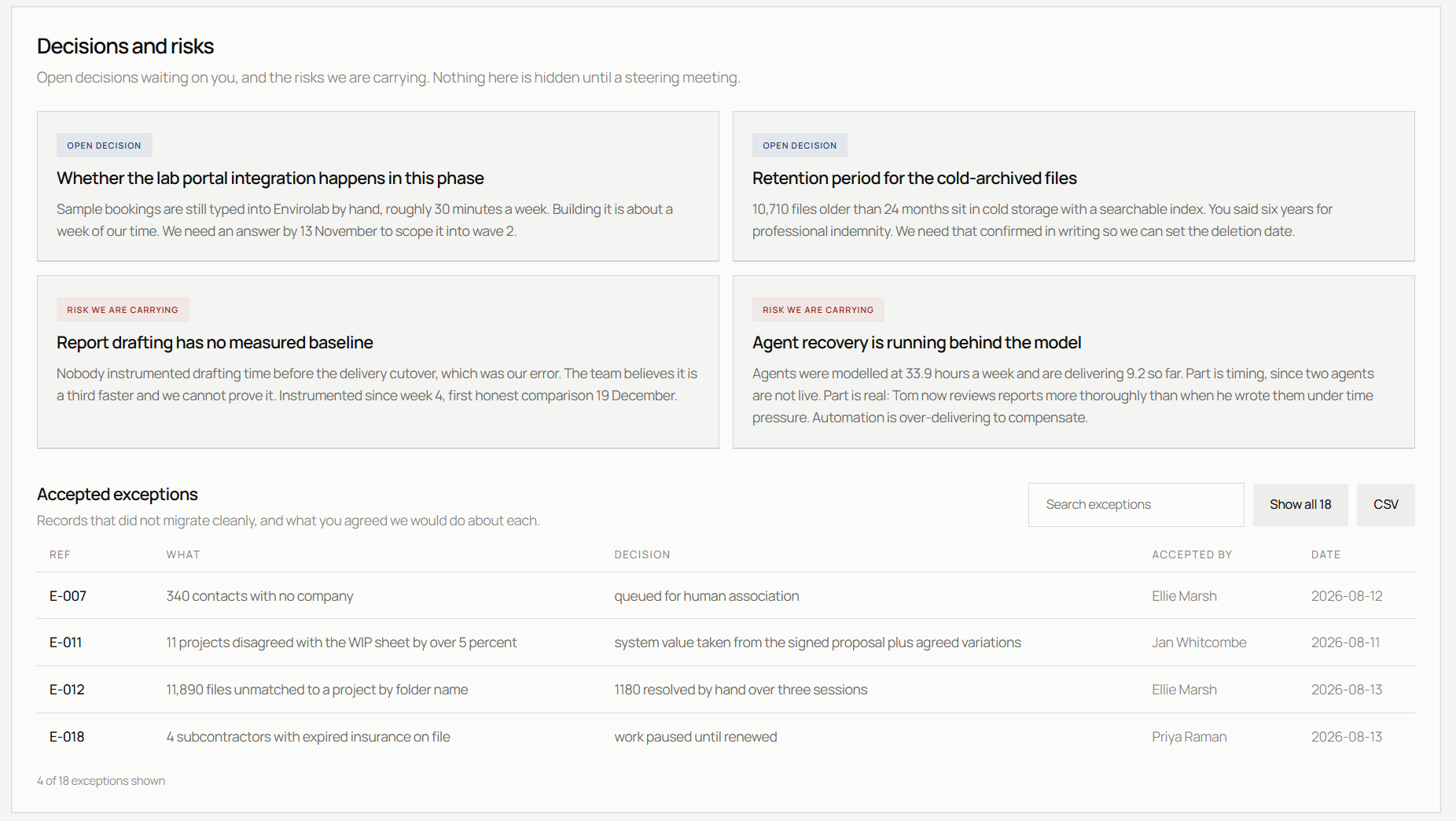

Delivery dashboard showing open decisions, carried risks, and accepted data exceptions with owners and dates.
Figure 03 · Report drafting had no measured baseline. No improvement claim is made for that workstream until instrumentation produces a comparison.

Useful proof says where it stops.

What the record supports

  • A dated operational snapshot of delivery progress
  • Recorded recovery split by consolidation and agents
  • Visible decisions, risks, exceptions, and owners
  • A traceable distinction between observed and projected values

What it does not claim

  • That the 74.3 modelled hours have been achieved
  • That future projected bars are production results
  • That every workstream had a complete before-state baseline
  • That this client-specific migration is the default delivery model
